New Build · Real project

Ground-Up Building: Start to Finish

One real ground-up project followed from excavation and foundations through structure, utilities, interiors, paving, and completion.

01

The challenge

The work progressed across earthwork, reinforced foundations, precast structure, underground utilities, interior build-out, and exterior completion as one coordinated construction effort.

02

The solution

The sequence shows each stage building on the last: establish the site, set the structure, install infrastructure, frame and rough in the interiors, then complete the envelope, parking, and occupied spaces.

03

The result

A completed multi-story building, finished site, and supporting outdoor space delivered from the original cleared construction area.

One real project · 17 stages

From open ground to completed building.

This sequence follows the same project in the client’s original numeric order. Scroll through each stage to see how site work, structure, utilities, interiors, and final completion build on one another.

  1. 01

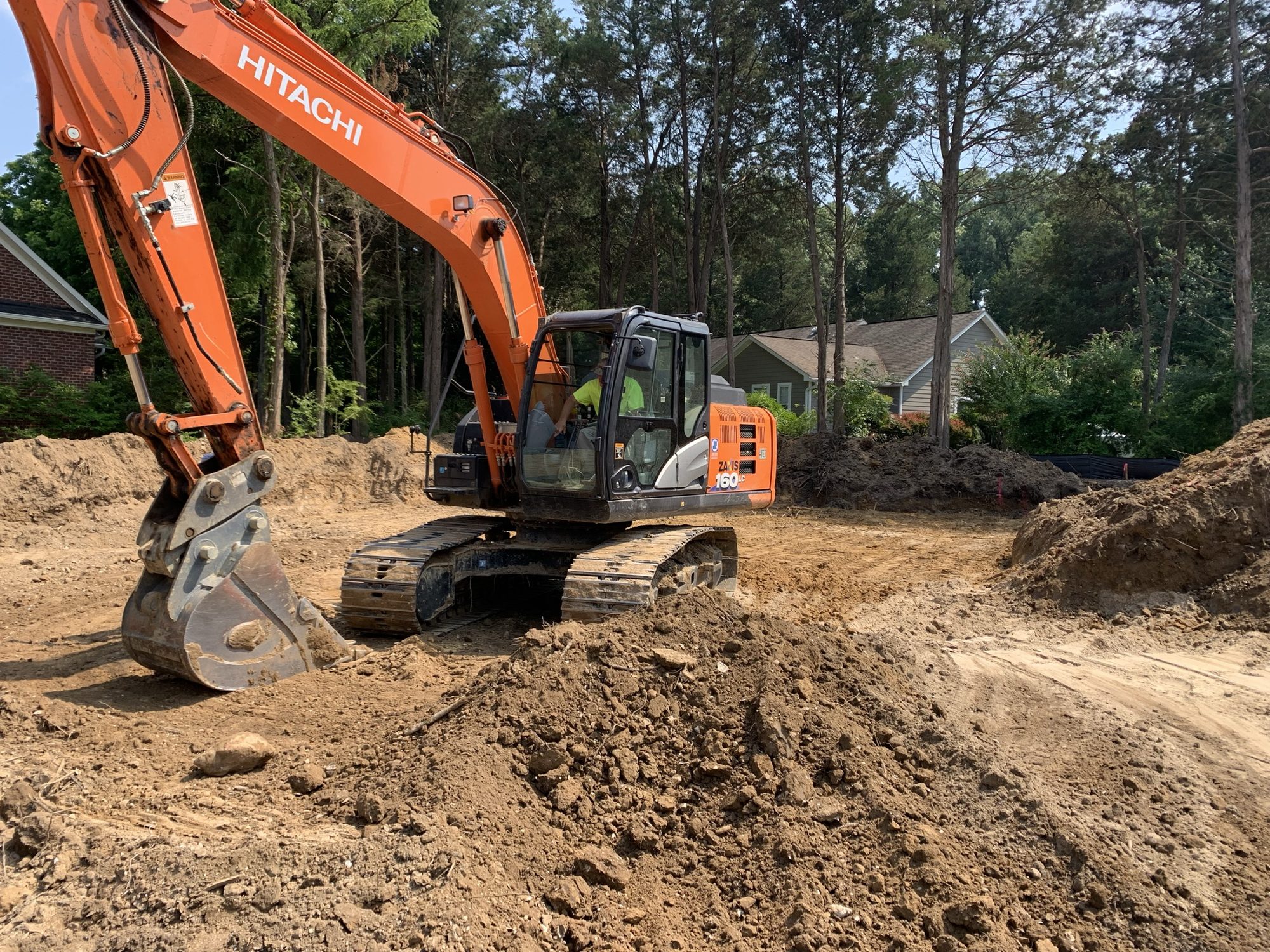

    Excavator moving soil across a cleared construction site

    Stage 01

    Site excavation

    Excavation begins in the cleared building area, establishing working grades and preparing the site for foundations.

  2. 02
    Worker beside reinforcing steel and formwork in an excavated foundation area

    Stage 02

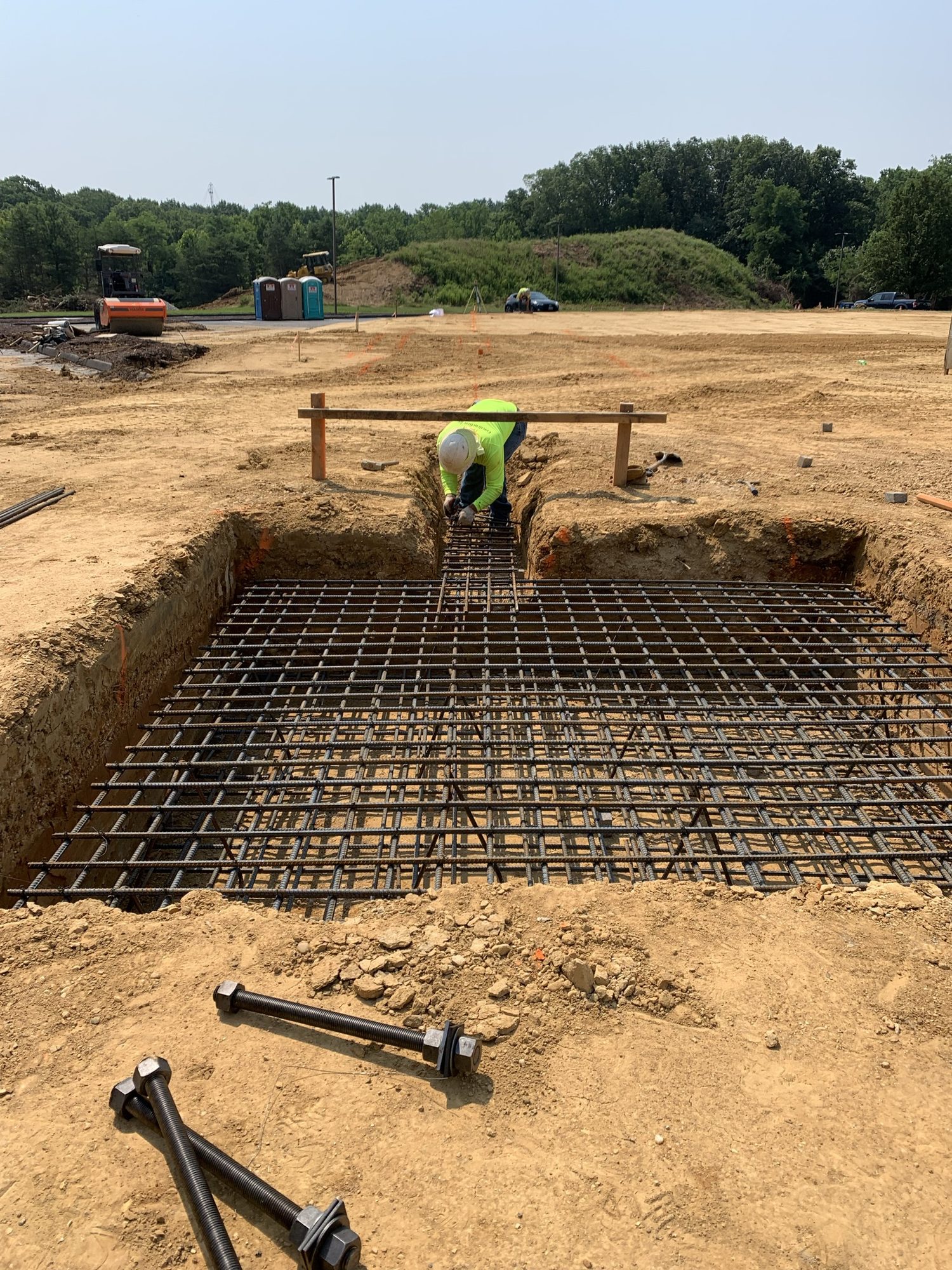

    Reinforced foundation work

    A tied reinforcing-steel mat and perimeter formwork prepare a foundation element for concrete placement.

  3. 03

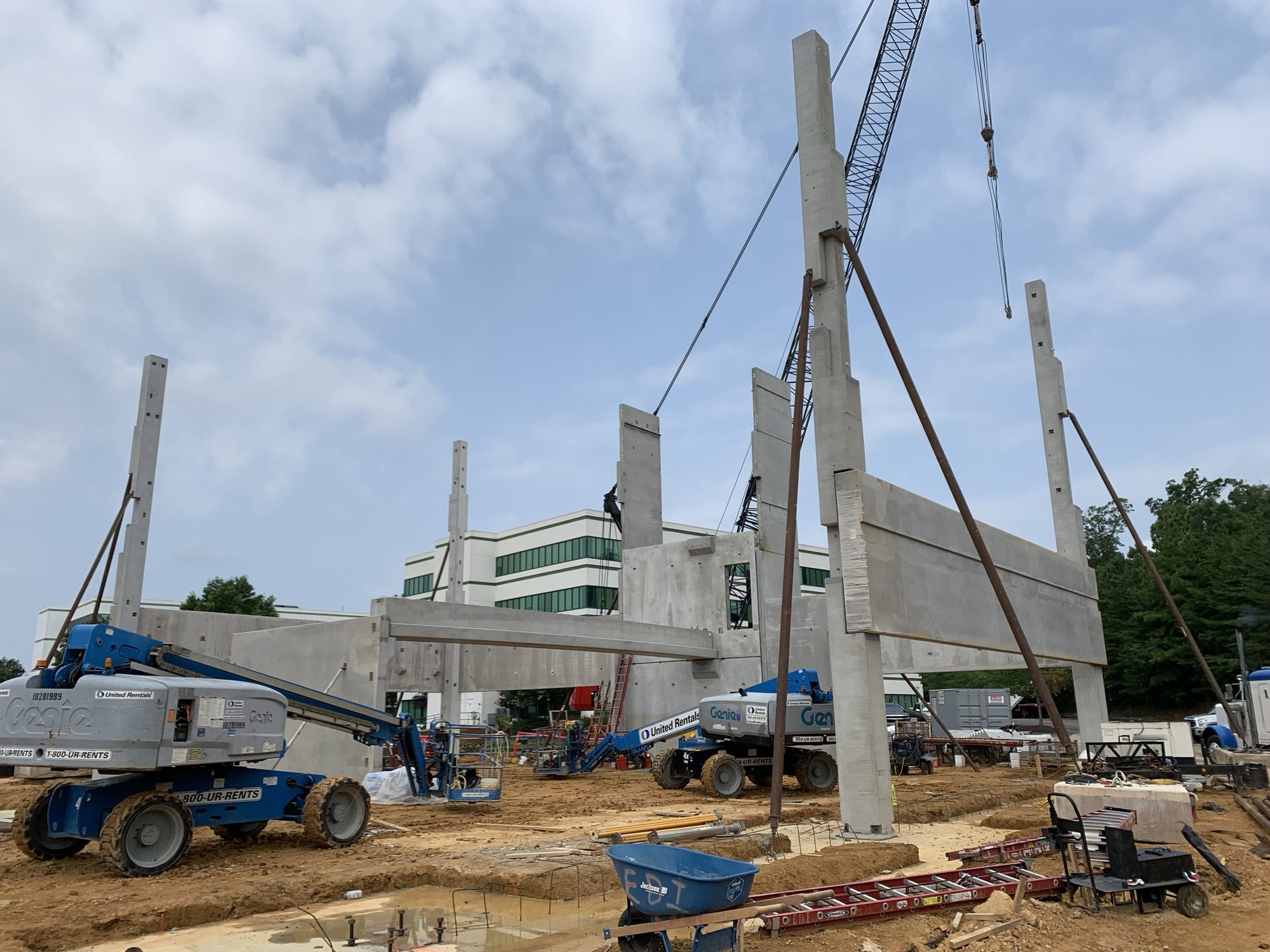

    Cranes setting tall precast concrete columns at an active building site

    Stage 03

    Precast structure begins

    Cranes set the first precast concrete columns and wall components as the building frame rises from the prepared site.

  4. 04

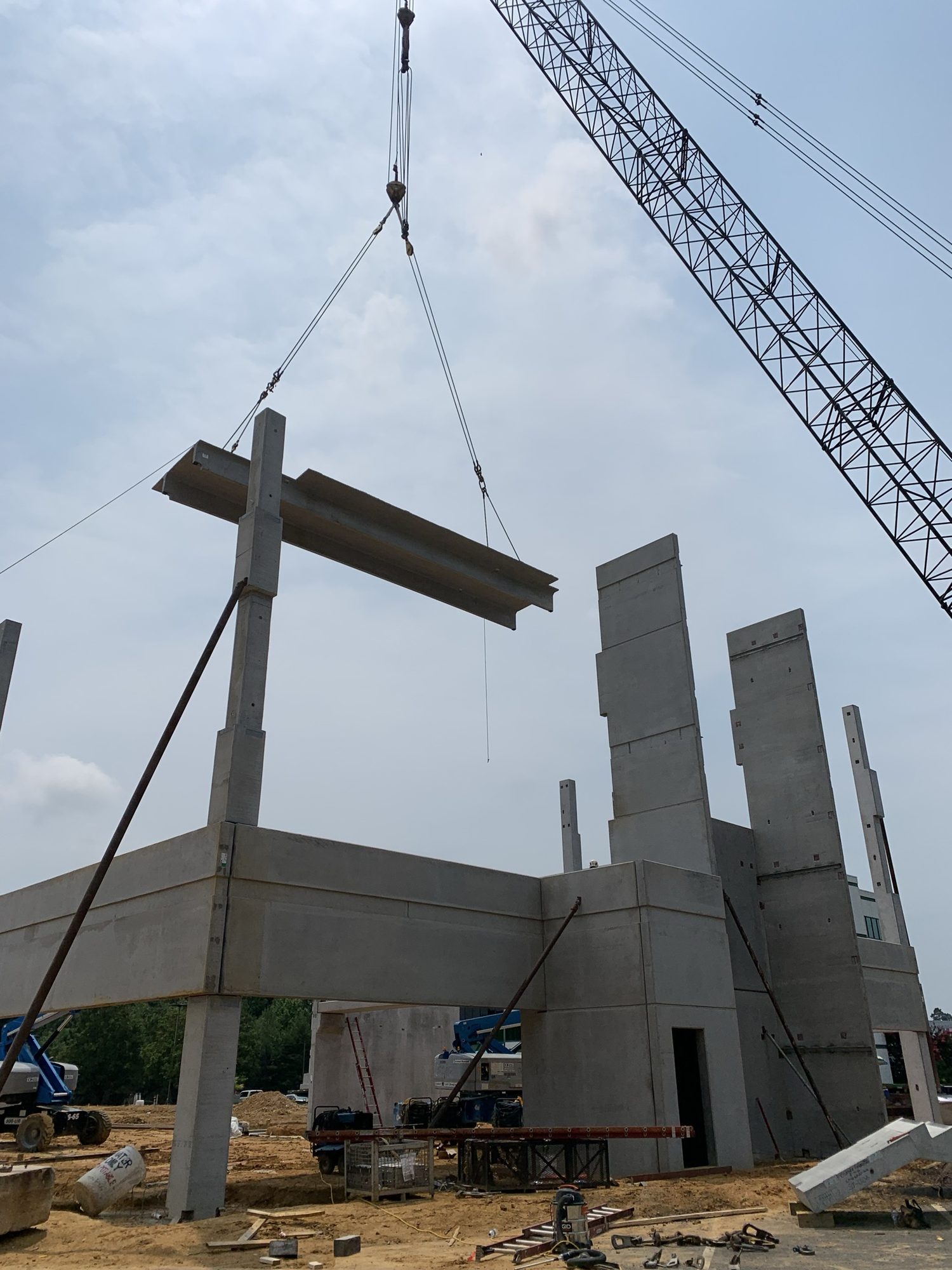

    Crane lifting a concrete structural member between precast columns

    Stage 04

    Structural framing advances

    A horizontal structural member is lifted between erected concrete columns, connecting the emerging frame.

  5. 05
    Partially assembled multi-story precast concrete building frame

    Stage 05

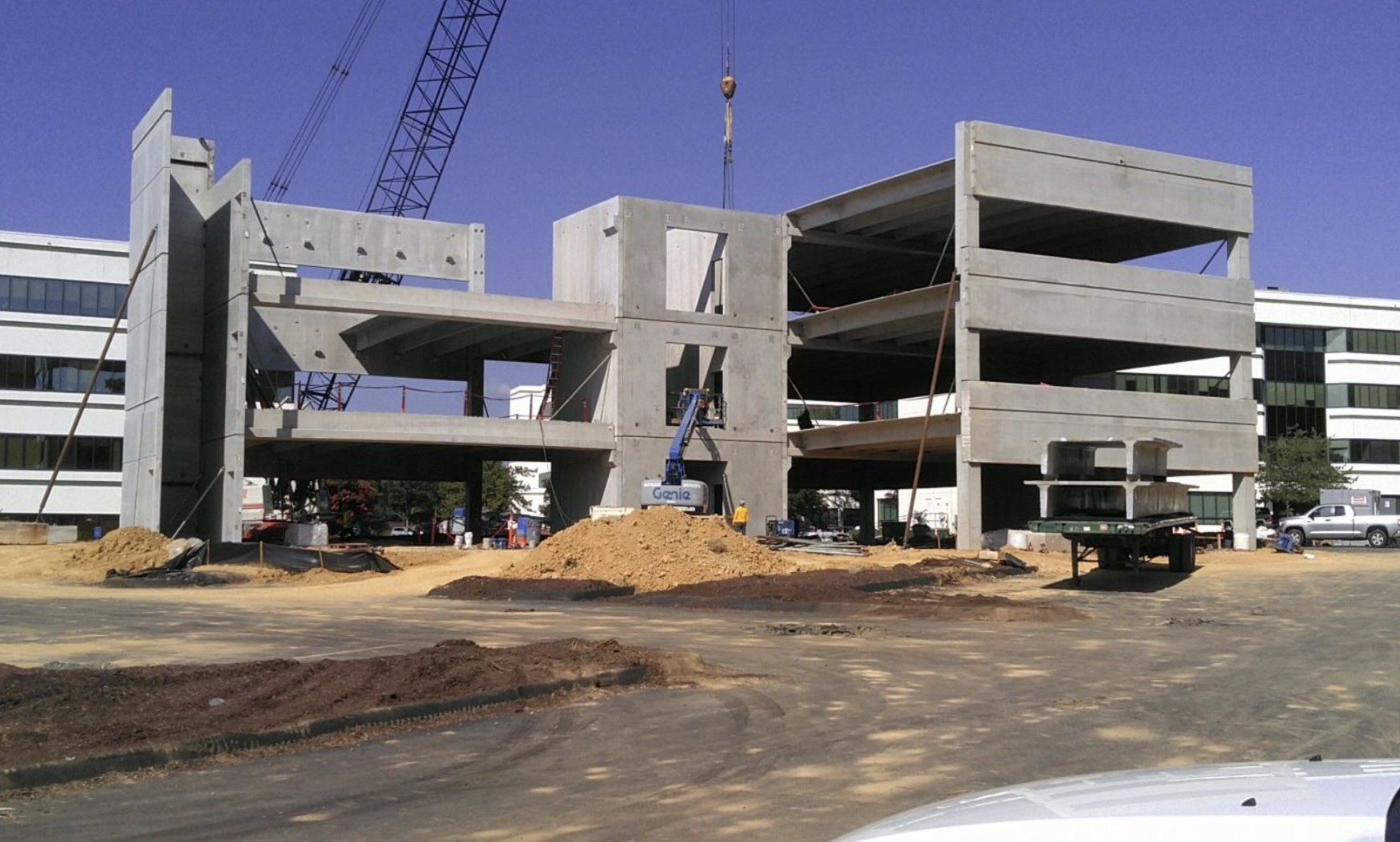

    Primary structure assembled

    The multi-level concrete frame takes shape with floor plates, vertical circulation elements, and major openings visible.

  6. 06
    Completed concrete building structure beside newly paved parking

    Stage 06

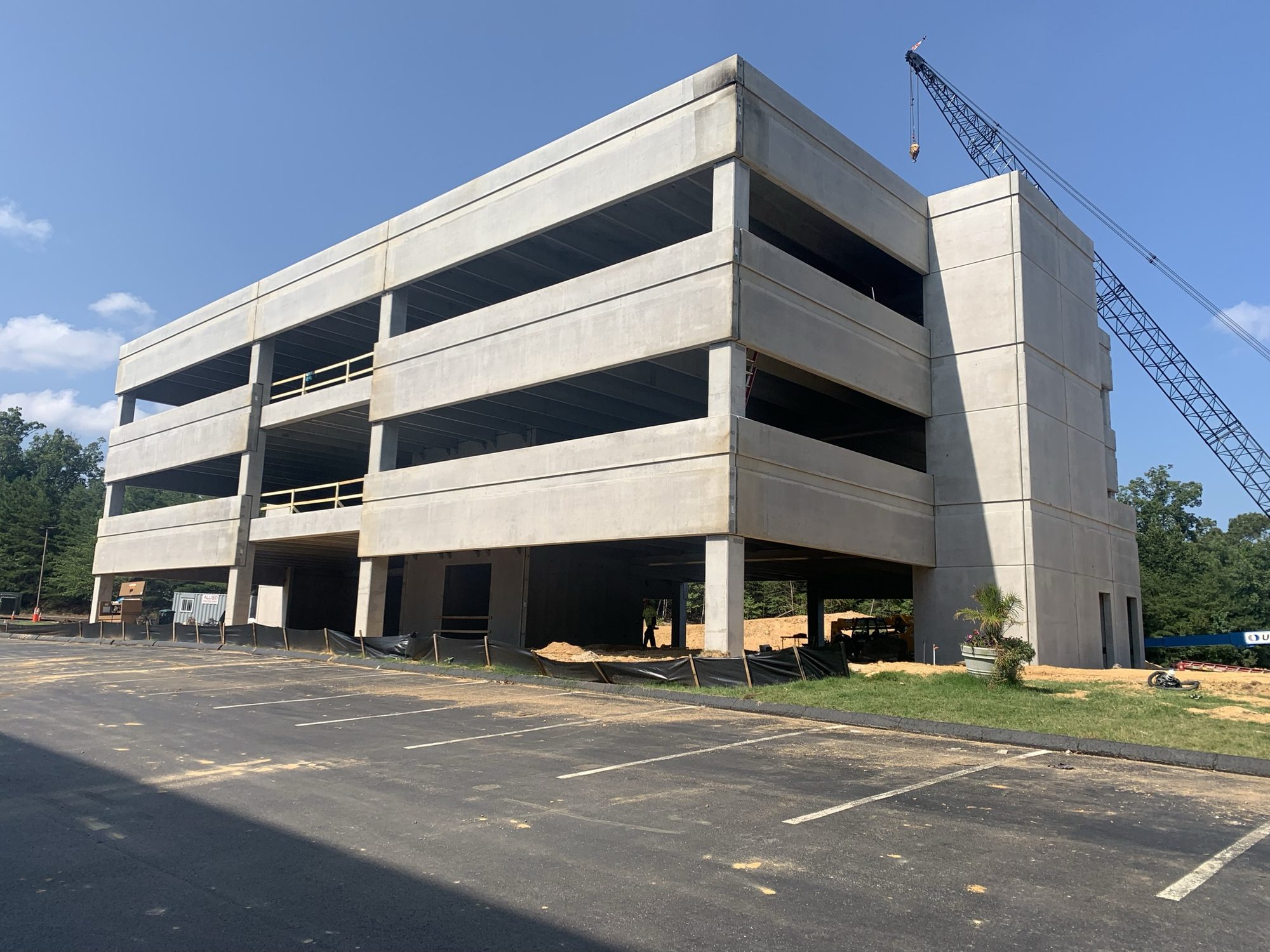

    Exterior structure complete

    The building shell and parking levels are established while exterior access and surrounding site work continue.

  7. 07

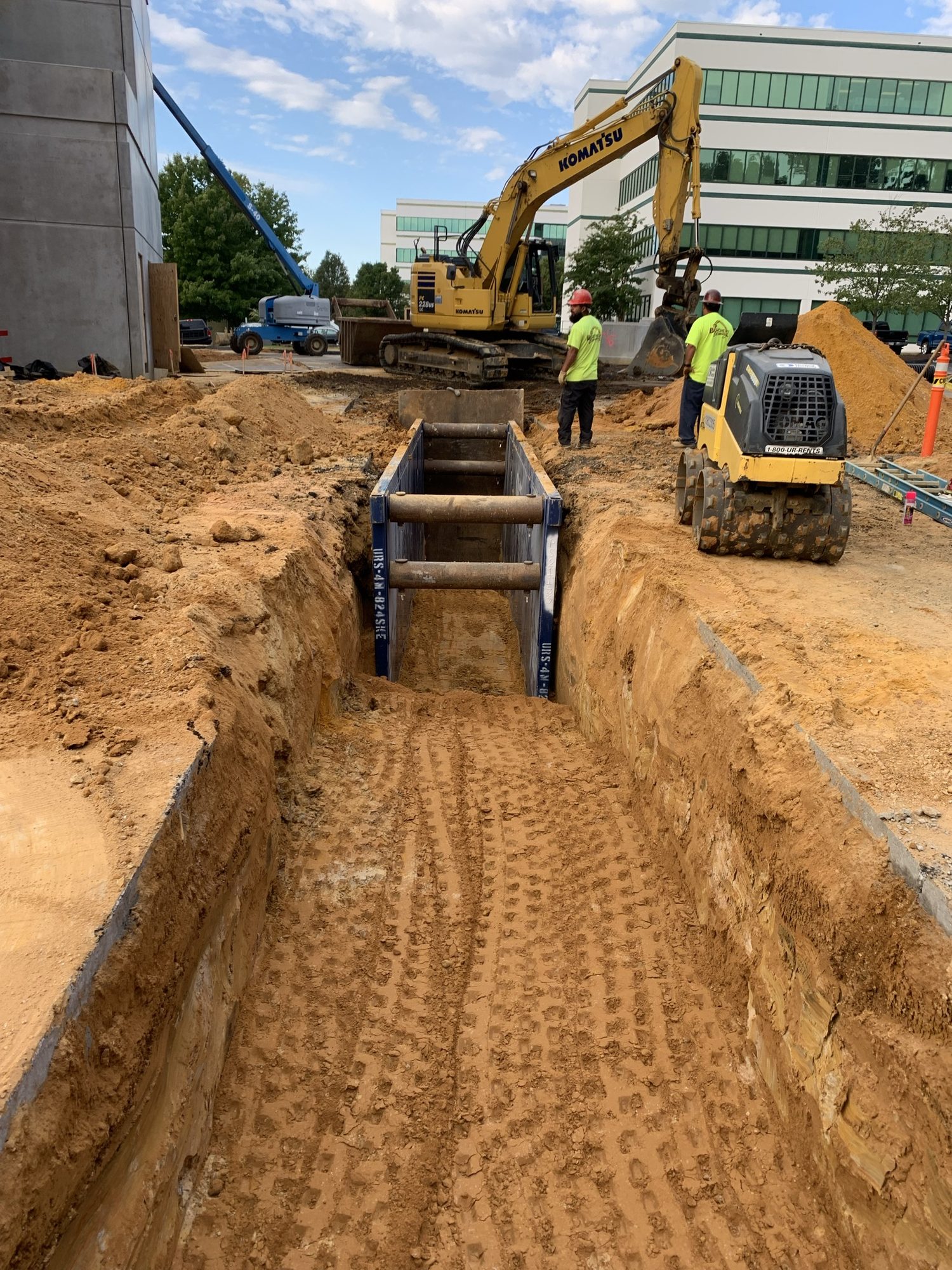

    Excavator beside utility pipes laid in a deep site trench

    Stage 07

    Underground utilities

    Crews install buried utility piping in a prepared trench before backfill and final grading.

  8. 08
    Grouped utility conduits running through an open trench toward a building

    Stage 08

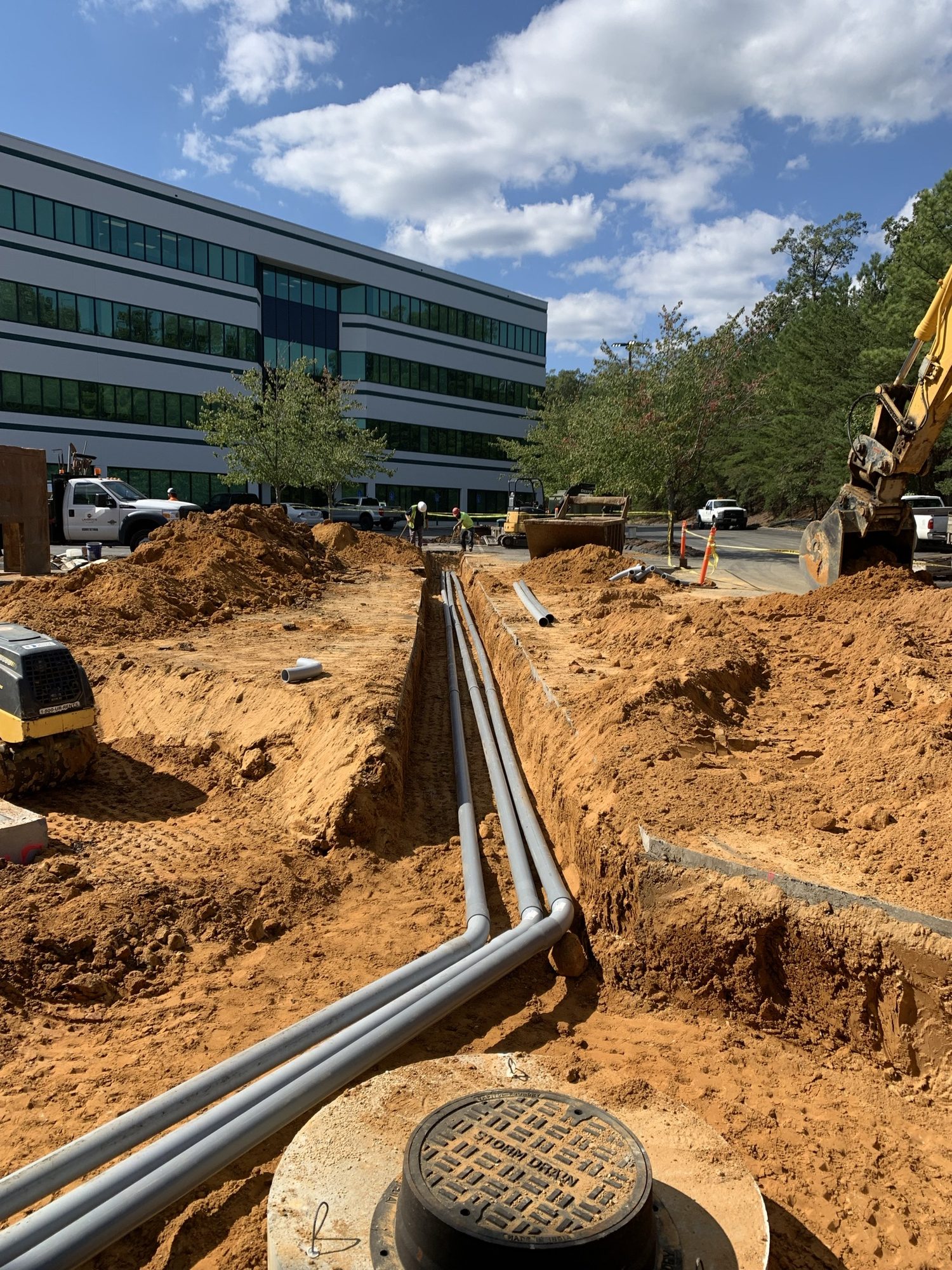

    Utility connections

    Multiple underground service lines are routed together toward the building and site infrastructure.

  9. 09
    Graded construction site in front of the new building

    Stage 09

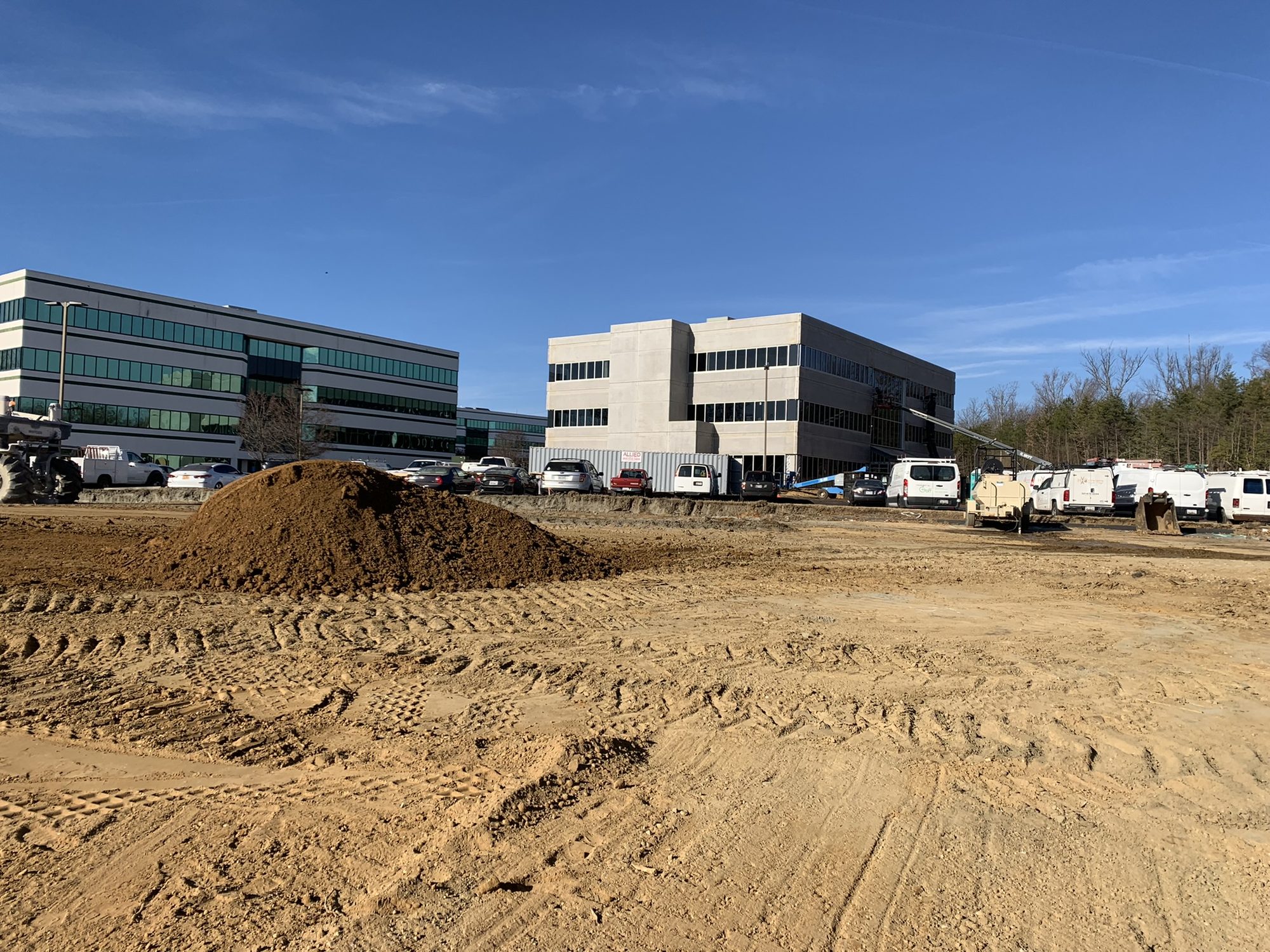

    Site grading

    The surrounding ground is shaped and compacted to prepare access, drainage, paving, and landscape areas.

  10. 10

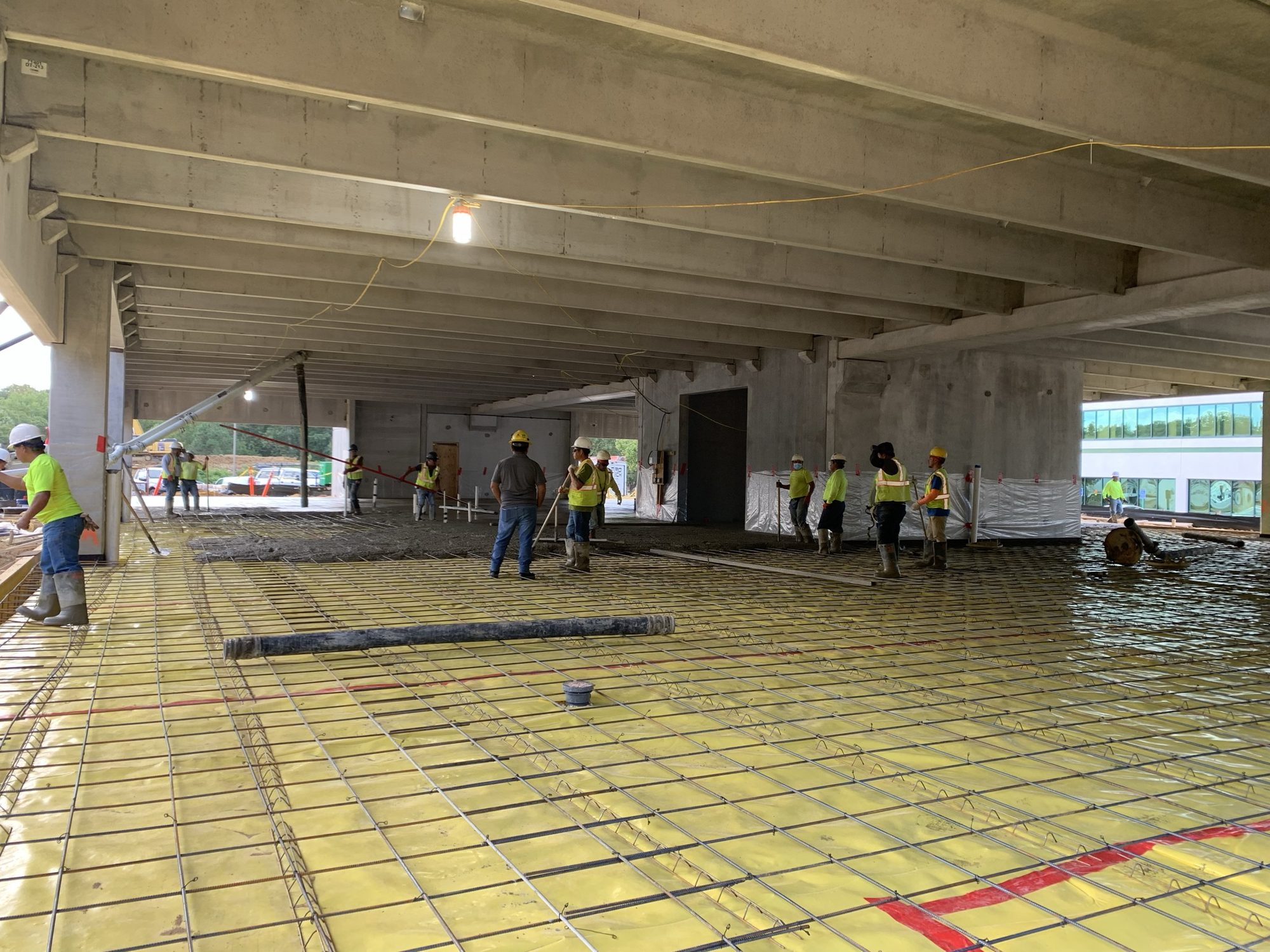

    Large interior floor area prepared with reinforcing grid and under-slab materials

    Stage 10

    Interior floor preparation

    Reinforcement and under-slab materials are laid out across a large floor area before concrete placement.

  11. 11

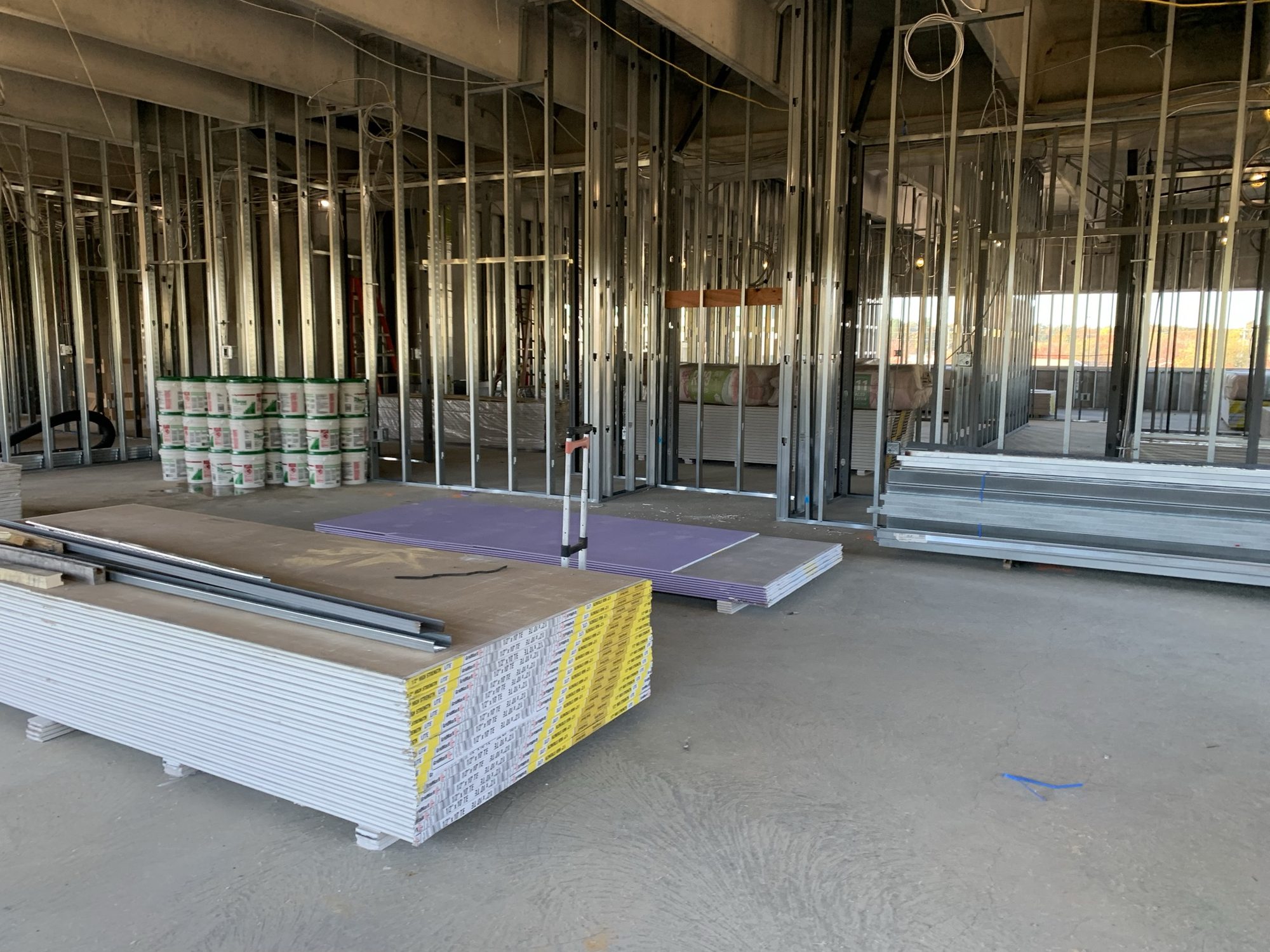

    Stacks of wallboard beside newly framed metal-stud interior partitions

    Stage 11

    Interior framing

    Metal-stud partitions define rooms and circulation paths inside the open concrete structure.

  12. 12
    Exposed plumbing and services installed within metal-stud walls

    Stage 12

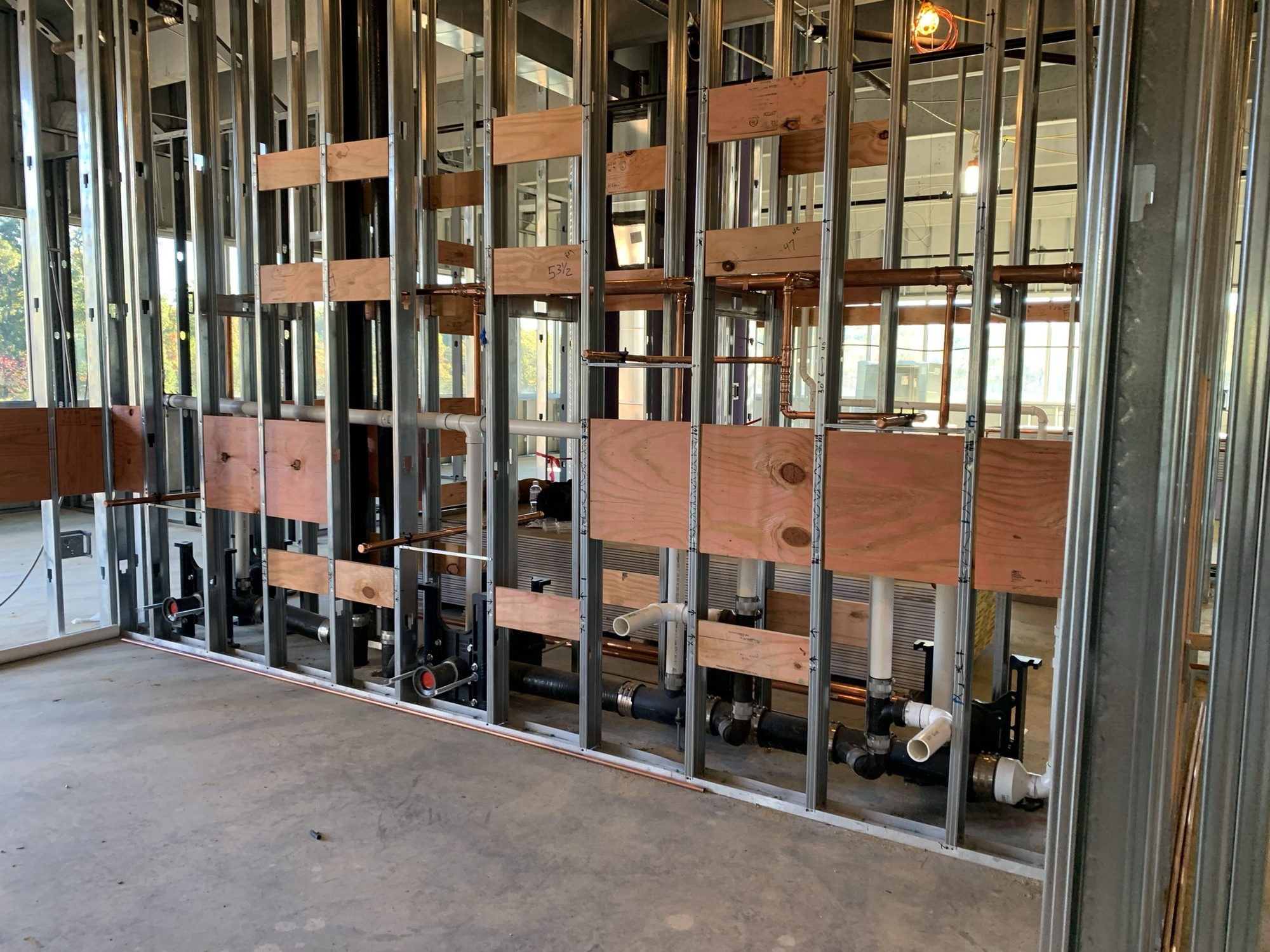

    Systems rough-in

    Plumbing and other in-wall services are coordinated within framed partitions before the walls are closed.

  13. 13

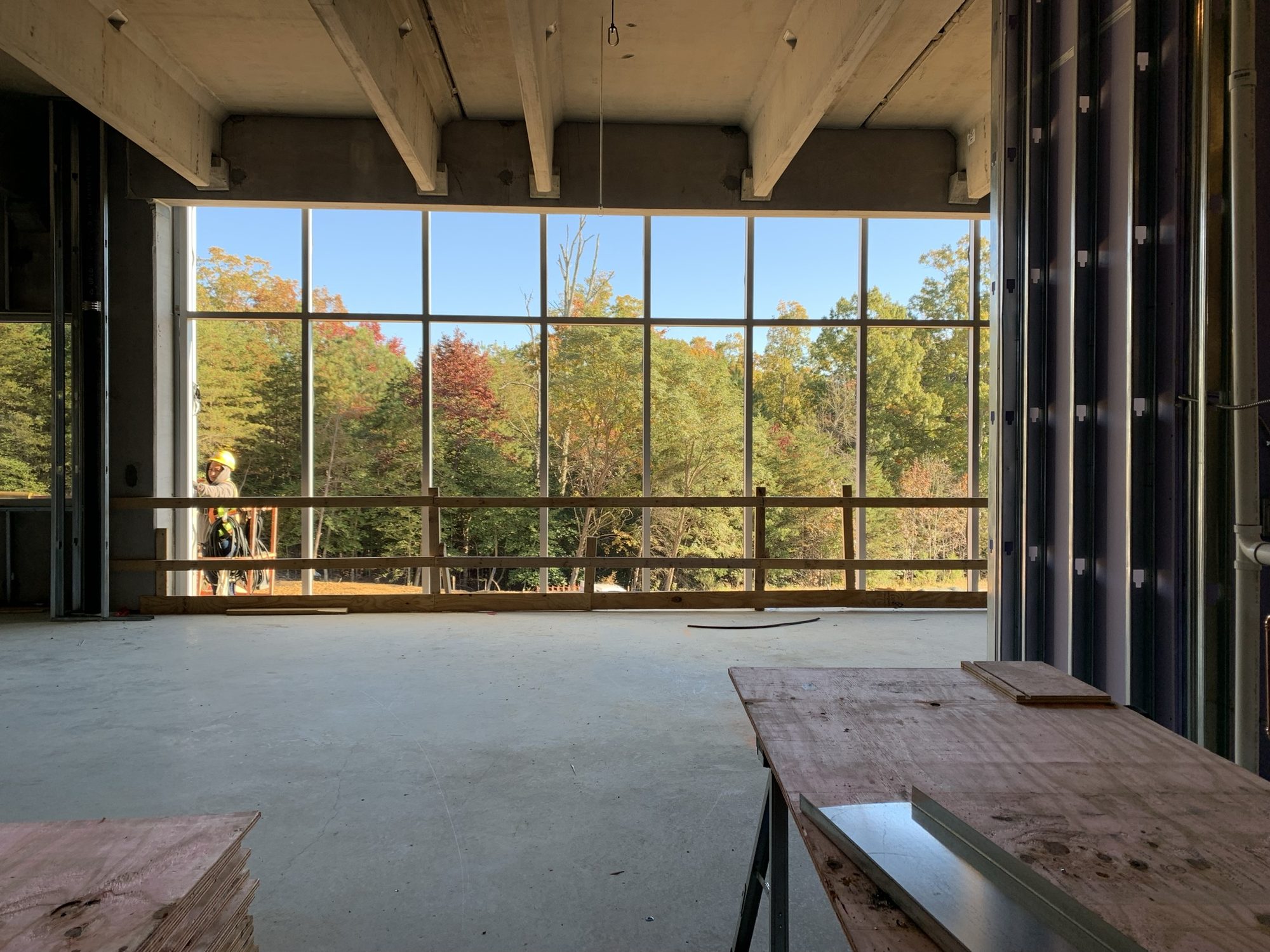

    Floor-to-ceiling exterior glazing viewed from an unfinished interior

    Stage 13

    Exterior glazing

    Window-wall framing and glass enclose the floor while interior construction continues at the perimeter.

  14. 14
    New overhead ductwork installed across an unfinished interior floor

    Stage 14

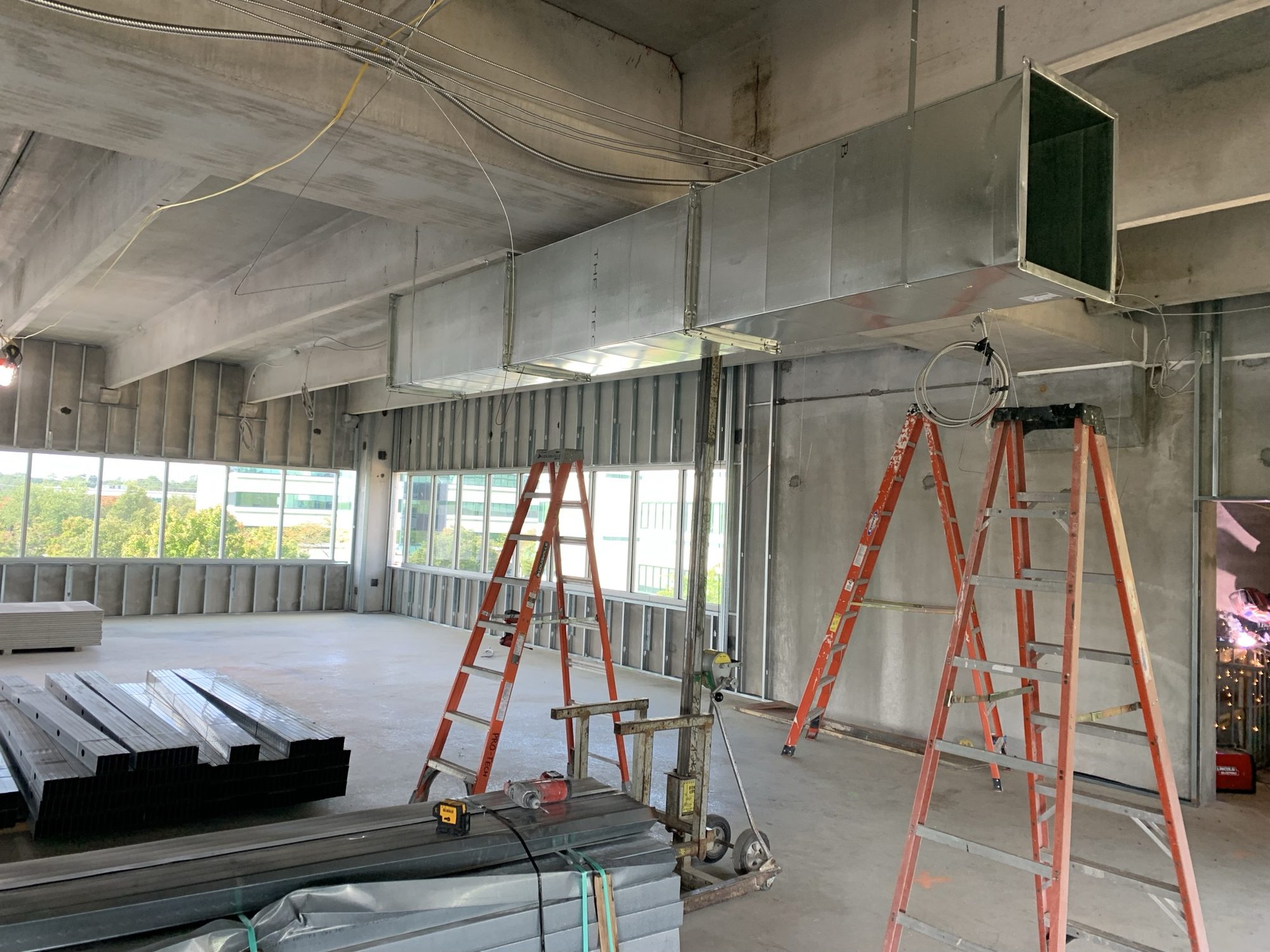

    Mechanical distribution

    Overhead ductwork and branch connections are installed and coordinated above the future ceiling plane.

  15. 15

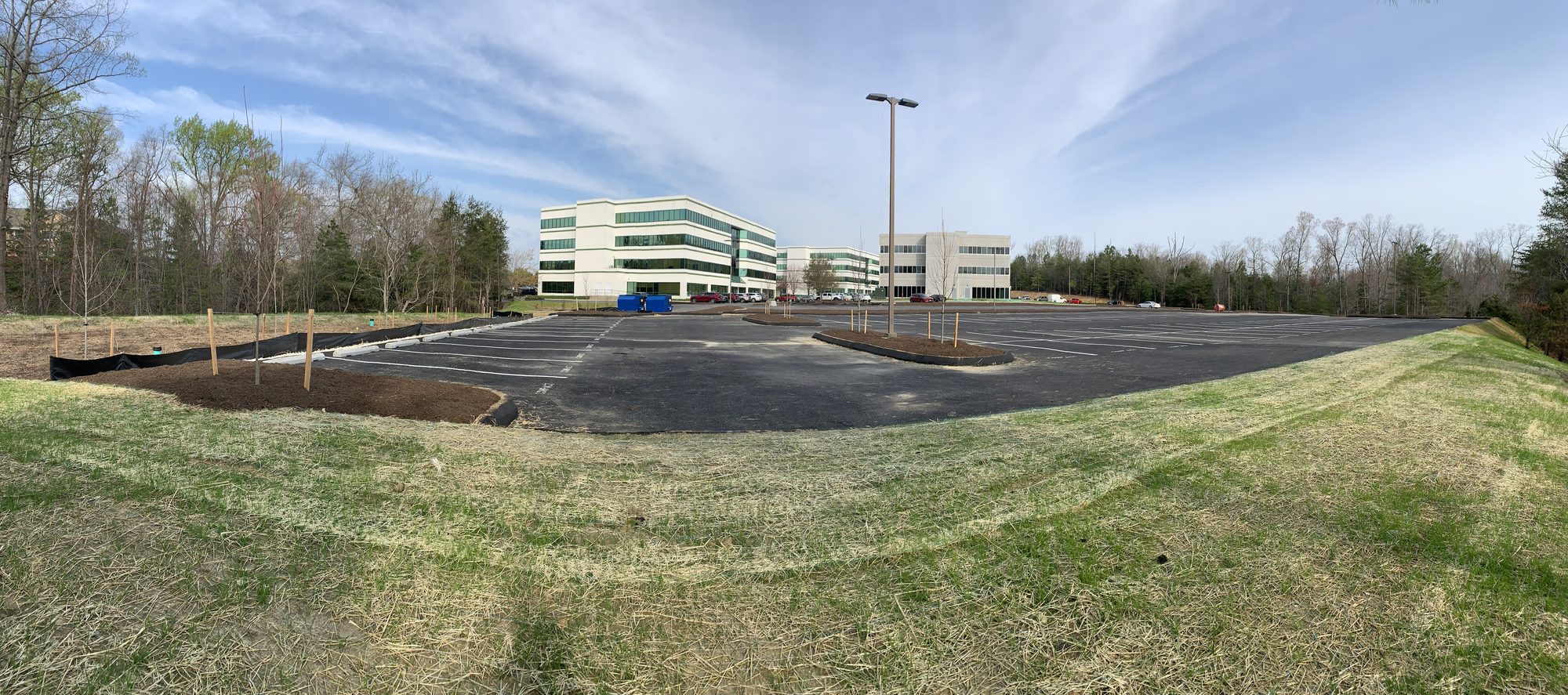

    Newly paved drive and parking areas leading to the completed building

    Stage 15

    Paving and site completion

    Finished drives, curbs, parking areas, and graded landscape zones establish the completed approach to the building.

  16. 16

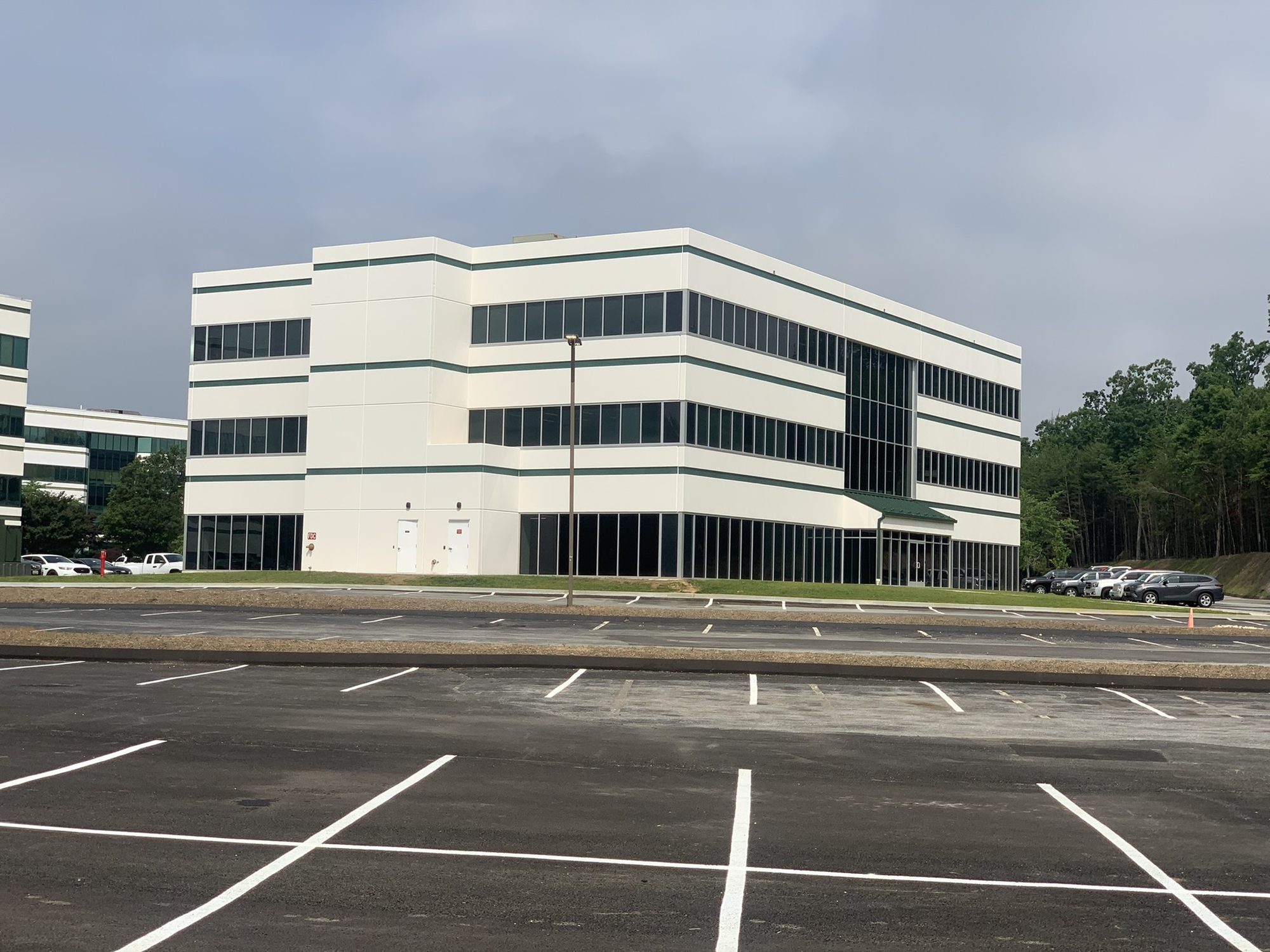

    Completed multi-story building with finished parking lot and sidewalks

    Stage 16

    Completed exterior

    The finished façade, striping, walks, and parking areas show the building ready for use.

  17. 17
    Close view of the completed building façade with glass and light-colored panels

    Stage 17

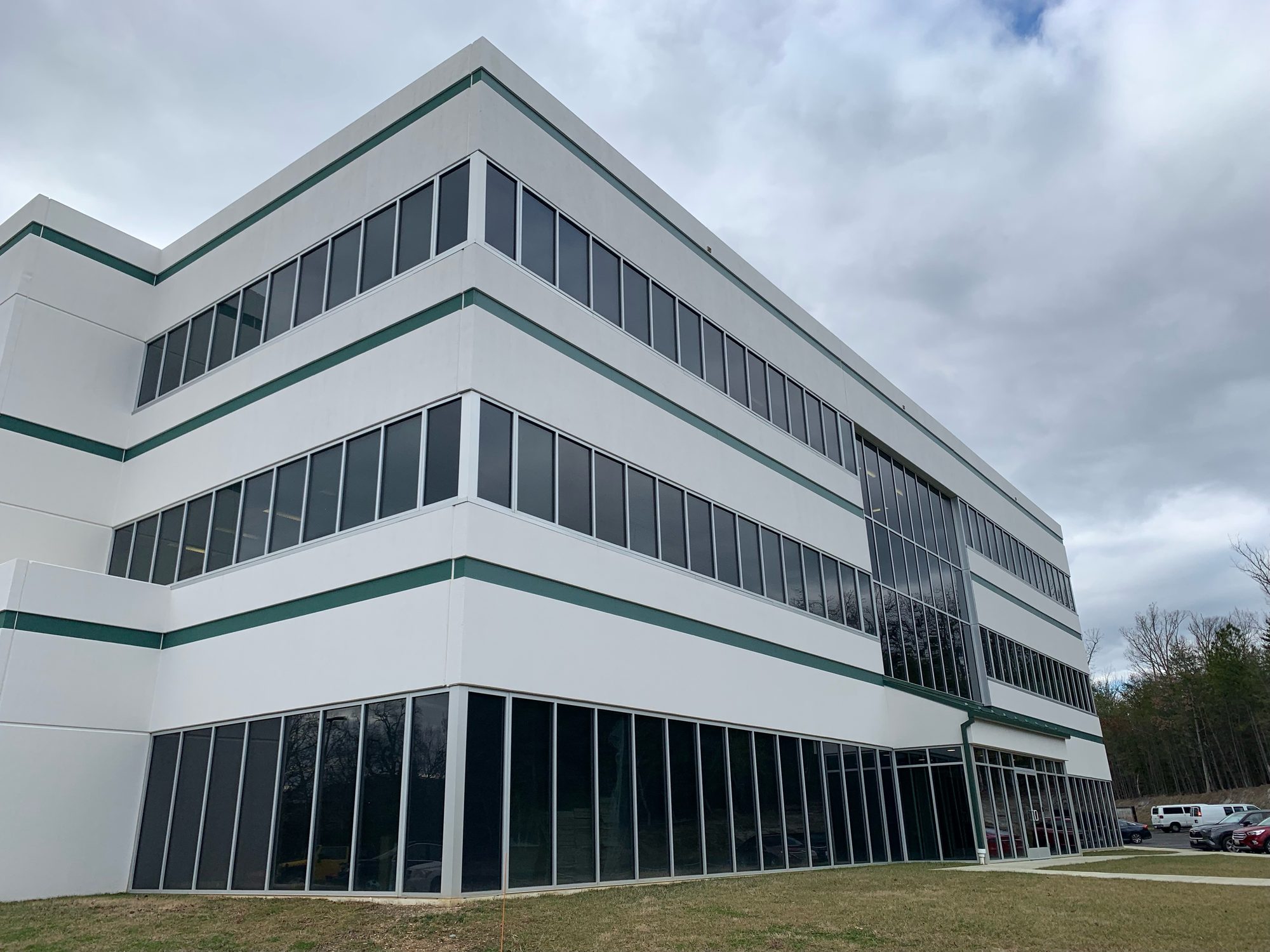

    Final building envelope

    The completed curtain wall and exterior panels form a clean, weather-tight façade around the occupied floors.
